Welcome to the 2021 & 2023 Bond Project!

2023 Proposal Background

The district-wide improvements plan was developed by a 27-member steering committee, commissioned by the Clawson Board of Education and comprised of a cross-section of the community, including parents, school teachers, administrators, staff, city leaders and school board members. The Board of Education reviewed and voted unanimously to move forward with the recommendation on May 1, 2023.

Click the images below to enlarge

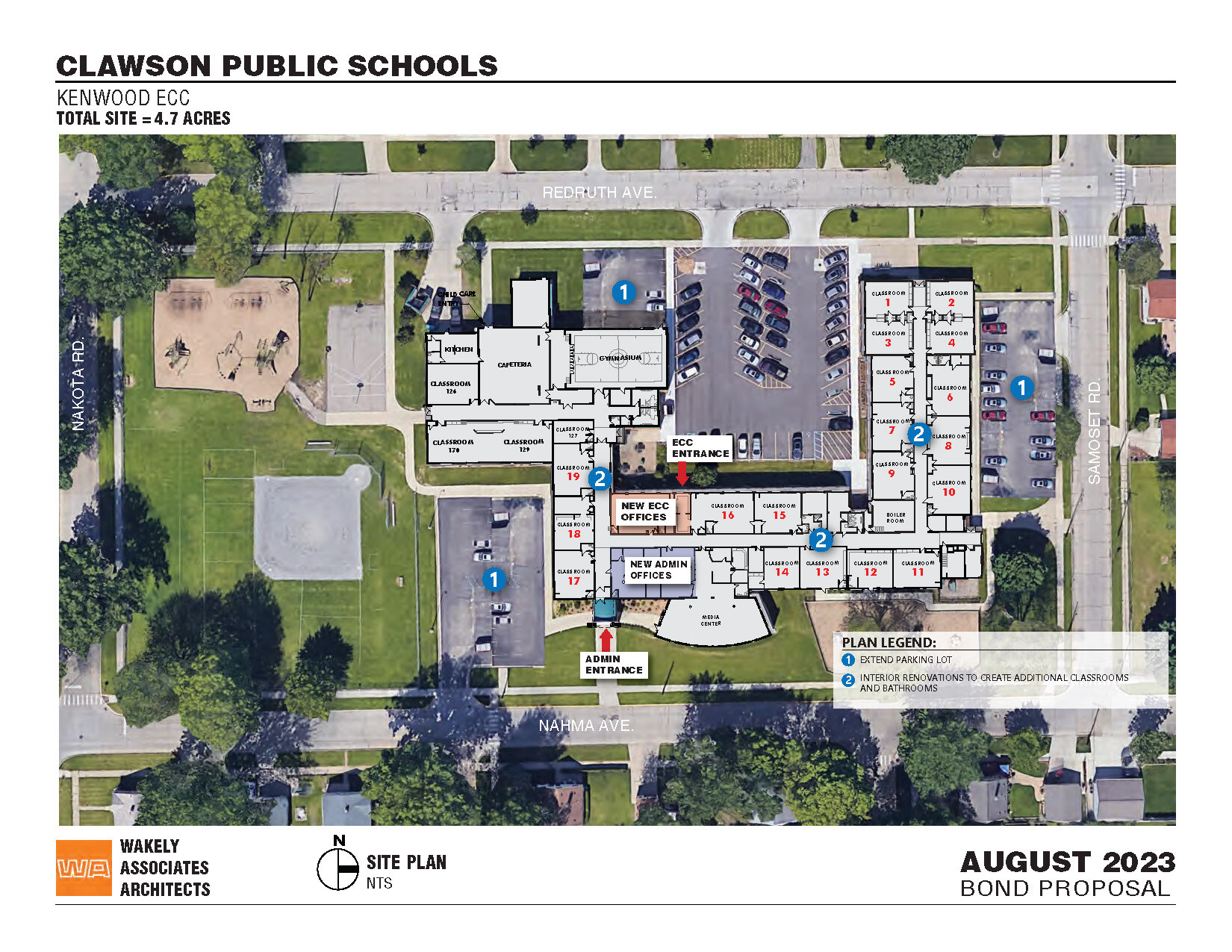

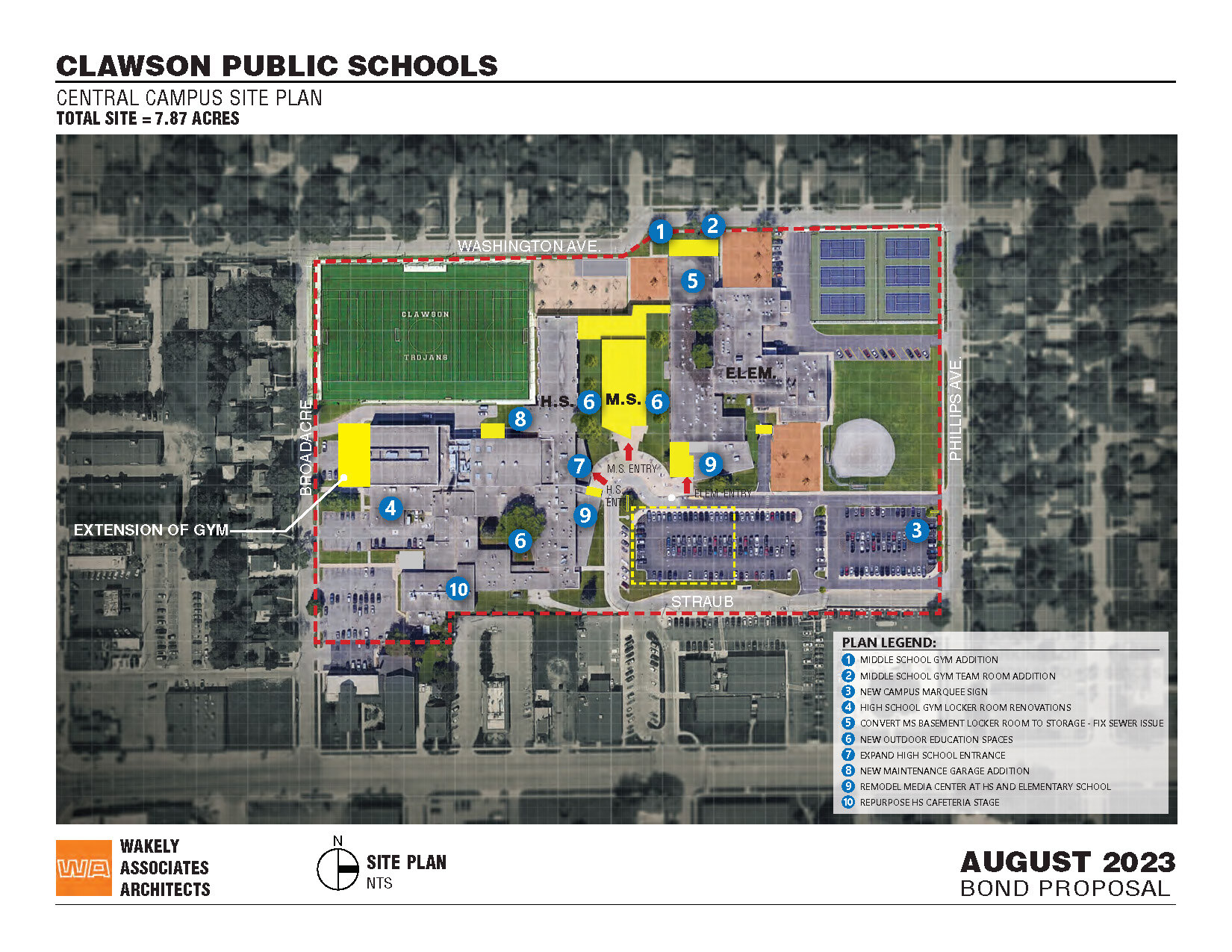

Central Campus Site Plan Kenwood Site Plan


SAFETY & SECURITY
  • Complete the replacement of exterior and interior doors with security upgrades district-wide
  • Expand/remodel High School entrance
  • Replace all exterior windows
ENHANCED LEARNING
  • Replace High School classroom casework, flooring and ceiling tiles and paint within all areas of High School
  • New outdoor education space
  • Remodel media centers district-wide
  • Kenwood (future Early Childhood Center) interior renovations/expand classrooms and bathrooms
PHYSICAL EDUCATION & INSTRUCTION
  • Elementary/Middle School team room addition
  • High School locker room renovations
INFRASTRUCTURE & ENERGY
  • District-wide bathroom upgrades
  • Façade repairs district-wide
  • Standardize PA/Clock systems district-wide
  • Complete replacement of LED lighting district-wide
  • Plumbing improvements at elementary gym
  • Maintenance garage addition to High School
SITEWORK & PARKING
  • Schalm/Baker demolition (in preparation of potential sale of property)
  •  New campus exterior/marquee sign
  •  Kenwood parking lot improvements
  •  Main campus perimeter fencing
ATHLETICS
  • Elementary/Middle School gym expansion
  • High School / Middle School cafeteria stage repurpose to multi-purpose room

Areas of Focus


Areas of Focus Bond 2023



Planning for the Future

Thank you Clawson Community! The passage of the August 8, 2023 ballot will allow Clawson to strengthen our district for the long-term and invest in safe, secure, 21st Century learning at all grade levels. It will create a secure, DK-12 Central Campus and dedicated Early Childhood Center, sized to meet current and future enrollment projections. The plan was developed by a 27-member steering committee, commissioned by the Board of Education and comprised of a cross-section of the community, including parents, business owners, school teachers, administrators, staff, students, city leaders, and school board members.

Tax Impact

While generating the necessary funds to invest in Early Childhood, Middle and High School students, the bond does not increase the current millage rate.

How can funds from a bond be spent?

Voter-approved bond funds can be spent on new construction, additions, remodeling, site improvements, athletic facilities, playgrounds, buses, furnishings, equipment, and technology. Funds raised through the sale of bonds cannot be used on operational expenses such as employee salaries and benefits, school supplies, and textbooks. Bond funds must be kept separate from operating funds and must be audited by an independent auditing firm.


Bond Progress Updates

View Archives
November Updates

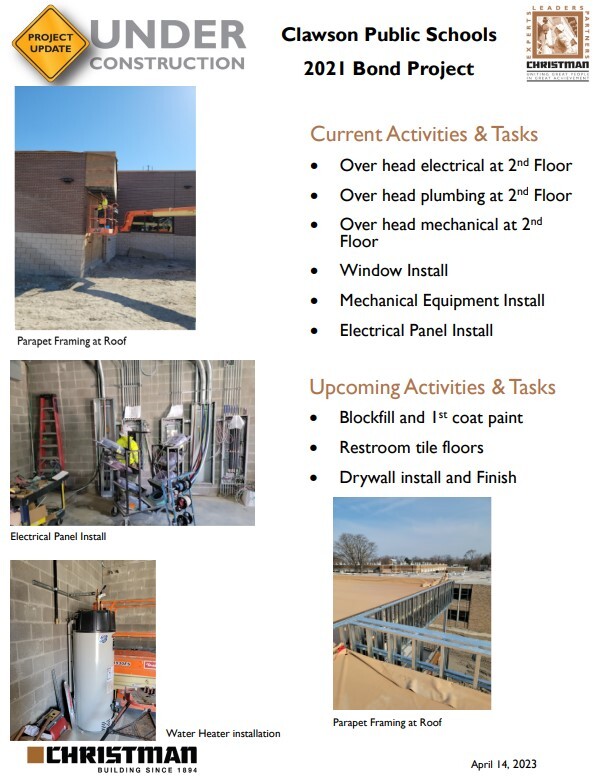

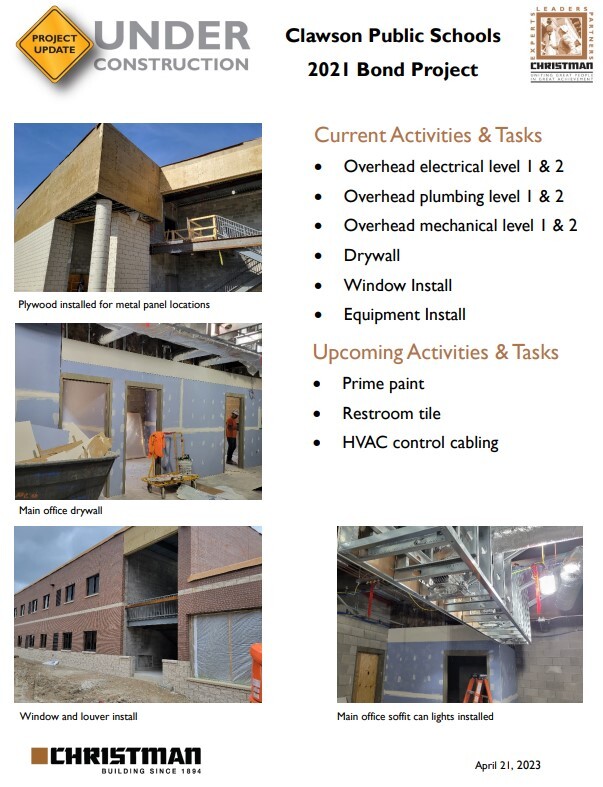

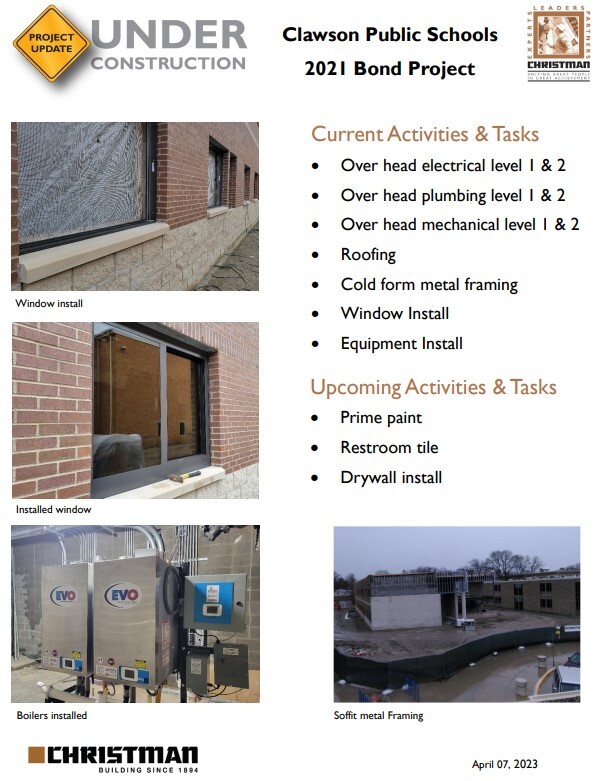

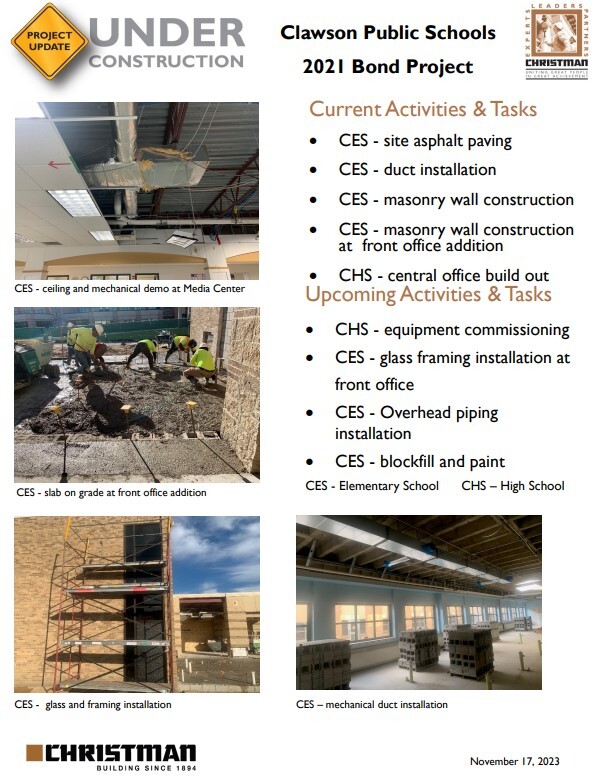

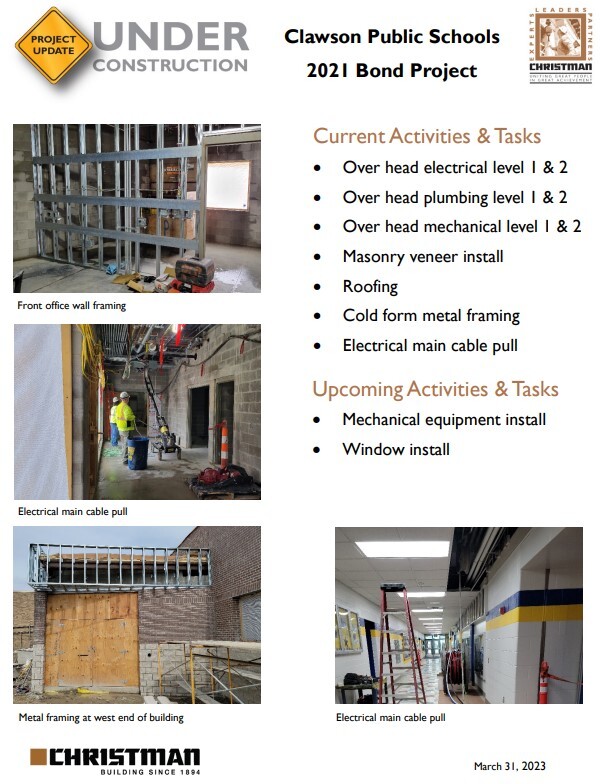

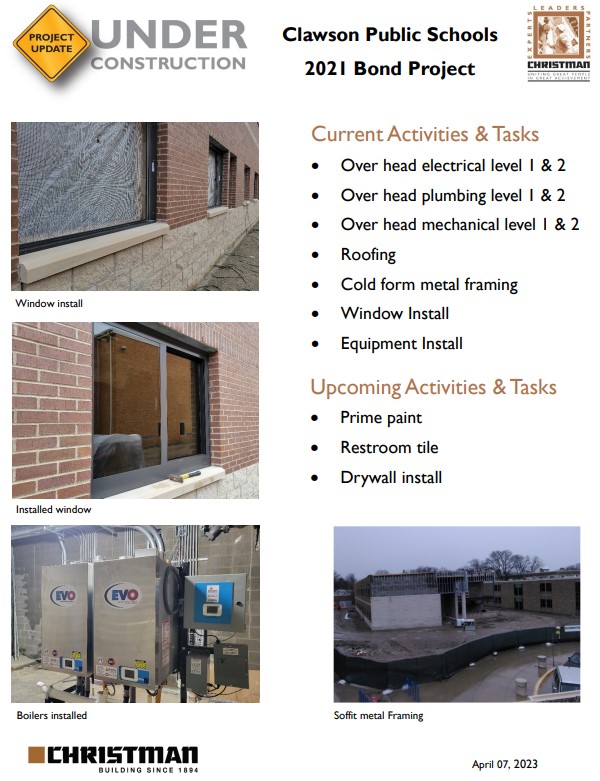

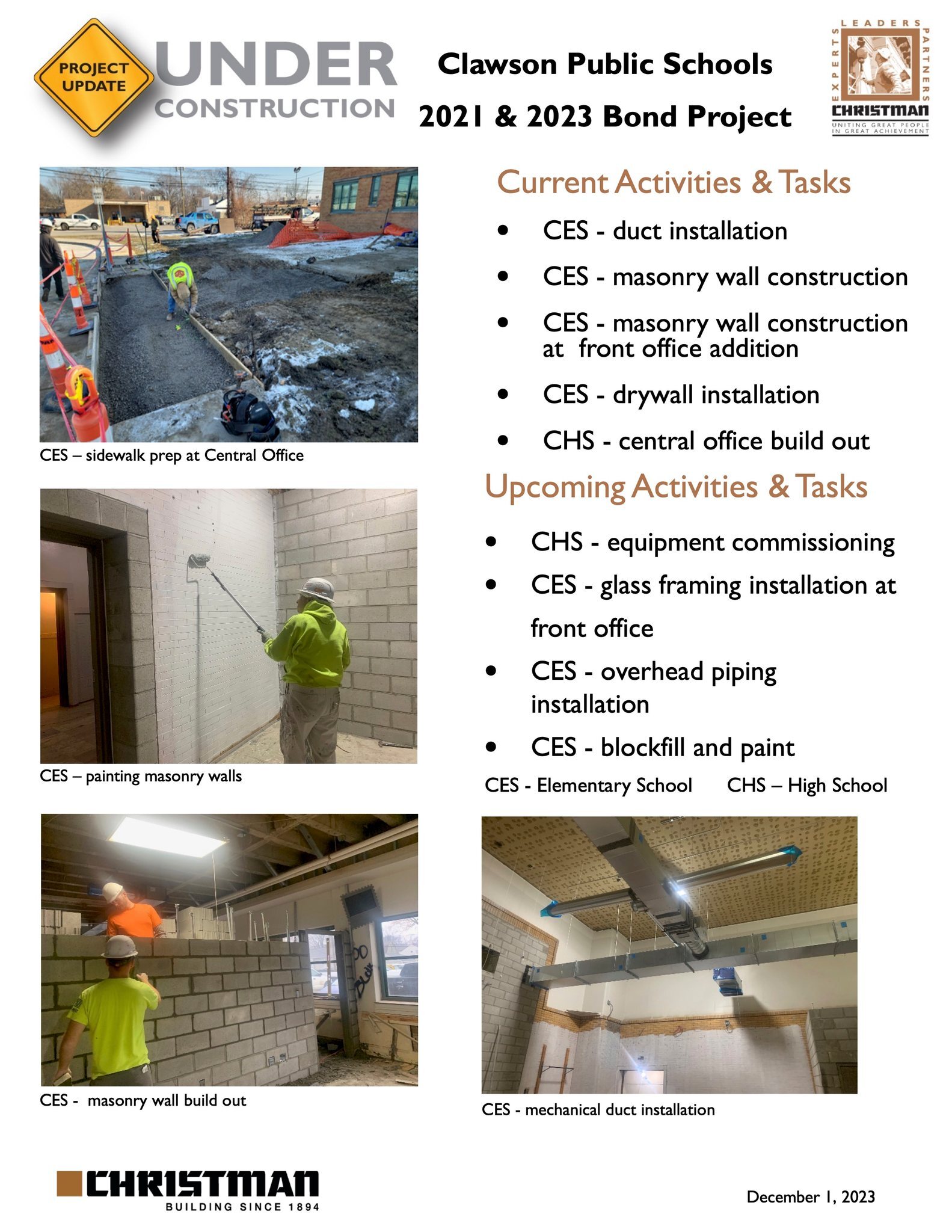

Bond Project - November 15, 2024 Update
CES - Gym Addition Wood Finishing Near Complete

Current Activities & Tasks

    • CES - Gym Equipment Divider Curtain Motor & Structure in place, pending wood floor completion for install.
    • CES - Gym Painting Complete.
    • CES - New Gym Wood Finishing near complete.
    • ECC - Demolition near complete.
    • ECC - Continue Overhead Mechanical /Electrical.
    • Schalm - Continue Backfill foundations / tunnels, Site Balancing.
